Whole-Home Renovation in Brentwood

A complete interior renovation of a 1971 post-and-beam house in Brentwood, taken back to a clean shell and rebuilt: new wide-plank flooring throughout, all walls and the vaulted ceiling re-skimmed and repainted, new interior doors and casing, and every trade sequenced so the house was handed over finished rather than in stages. These are the handover photographs, shot before the furniture went in, because an empty room is the only honest way to show flat walls, straight door lines and a floor that runs level from room to room.

The property

A single-storey post-and-beam house in Brentwood, built in 1971, with an open vaulted ceiling and exposed collar ties over the main living space. Houses from this era look simple and are not. The frame has settled, so almost nothing is truly plumb or level, the original wall finish is often plaster rather than modern drywall, and the electrical is undersized for how people actually live now.

What the client asked for

The owner had just bought the house and described the job as cosmetic. Her words were roughly: new floors, fresh paint, make it feel light, we want to move in six weeks. She did not want a remodel, she wanted the house to stop looking tired.

What we found that changed the scope

Once the old flooring came up, the slab and subfloor were out of level by enough that a floating floor would have telegraphed every dip and creaked within a year. The vaulted ceiling had been patched at least twice with different textures, so it read as three different surfaces under the skylight light. Two circuits in the living area were still original cloth-insulated runs feeding modern loads. We stopped, photographed everything, priced the corrections separately and let her decide before we bought a single box of flooring.

How we worked, in order

  1. Full protection and containment, then strip out flooring, base, casing and the old ceiling patches.
  2. Corrected the substrate first. Self-levelling compound over the low areas and mechanical fixing where the subfloor moved, checked with a long straightedge rather than by eye.
  3. Electrical corrections while the walls were open, so nothing had to be reopened later.
  4. Skim coated the whole ceiling plane and the walls to one continuous finish instead of blending into old texture.
  5. Primed everything, then three coats of finish paint on walls and ceiling.
  6. New wide-plank flooring laid in one direction through every room and hallway so there are no thresholds breaking up the sightlines.
  7. New interior doors, casing and base last, scribed to the finished floor.
  8. Final punch list walked with the client room by room before handover.

The decision we are proud of

Levelling the substrate before we ordered the floor. It added days to the schedule and it is invisible in the finished photographs, which is exactly why most contractors skip it. The alternative is to lay a good floor over a bad base: it looks perfect on handover day, then it develops soft spots, gaps at the ends of the boards and that hollow tap when you walk across it. At that point the only fix is to pull the entire floor. We would rather lose three days than hand back a floor with a countdown on it.

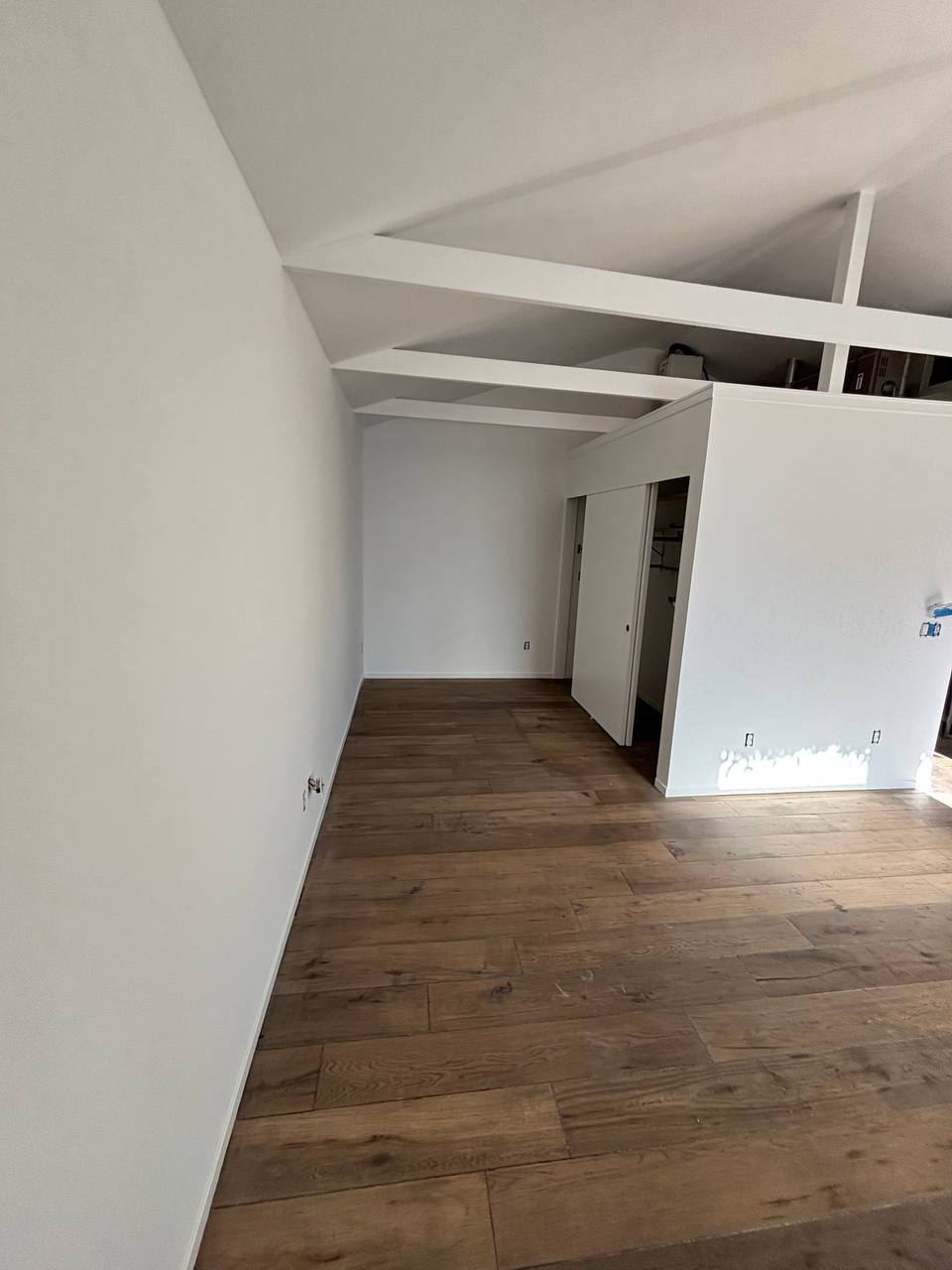

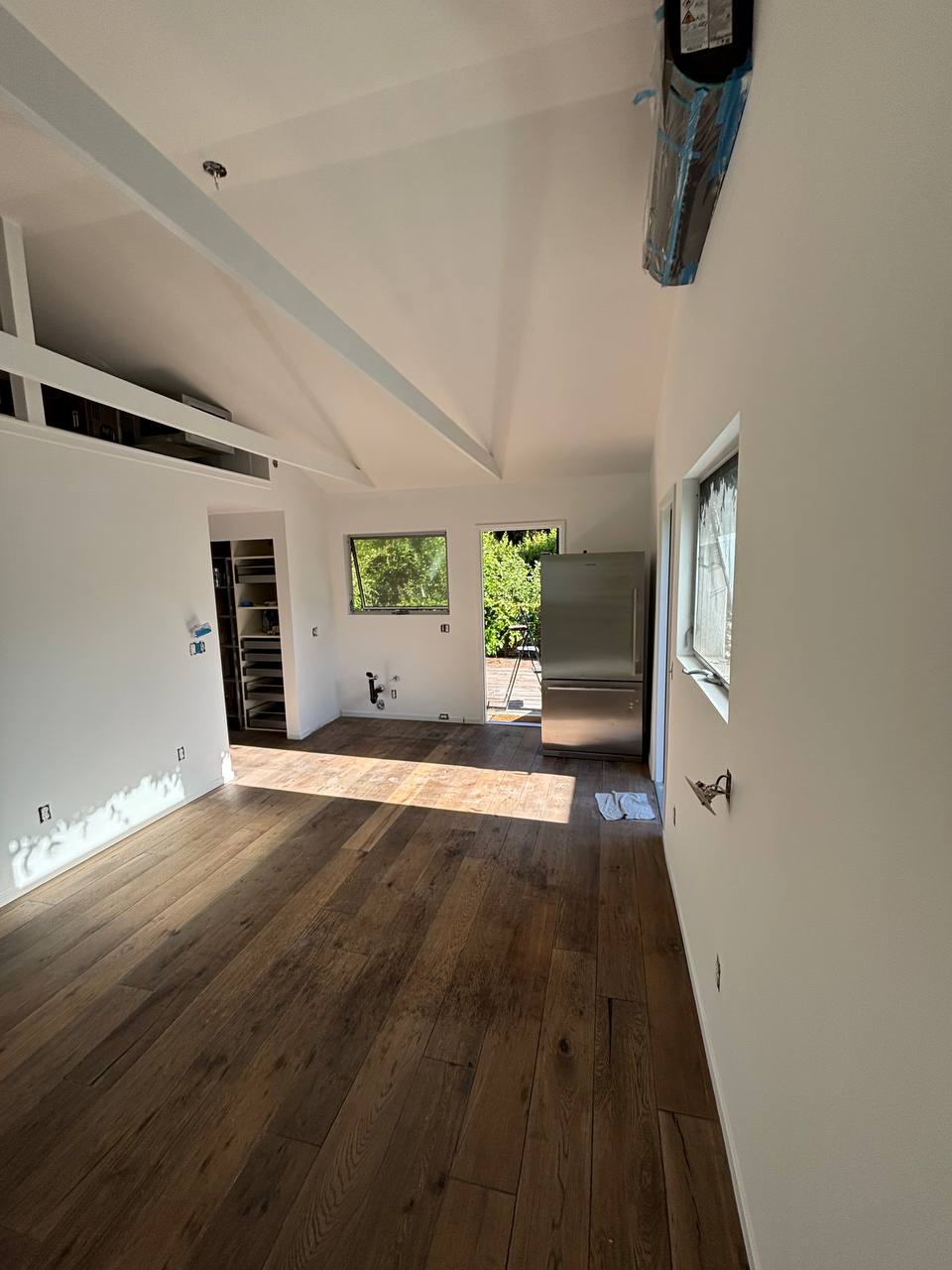

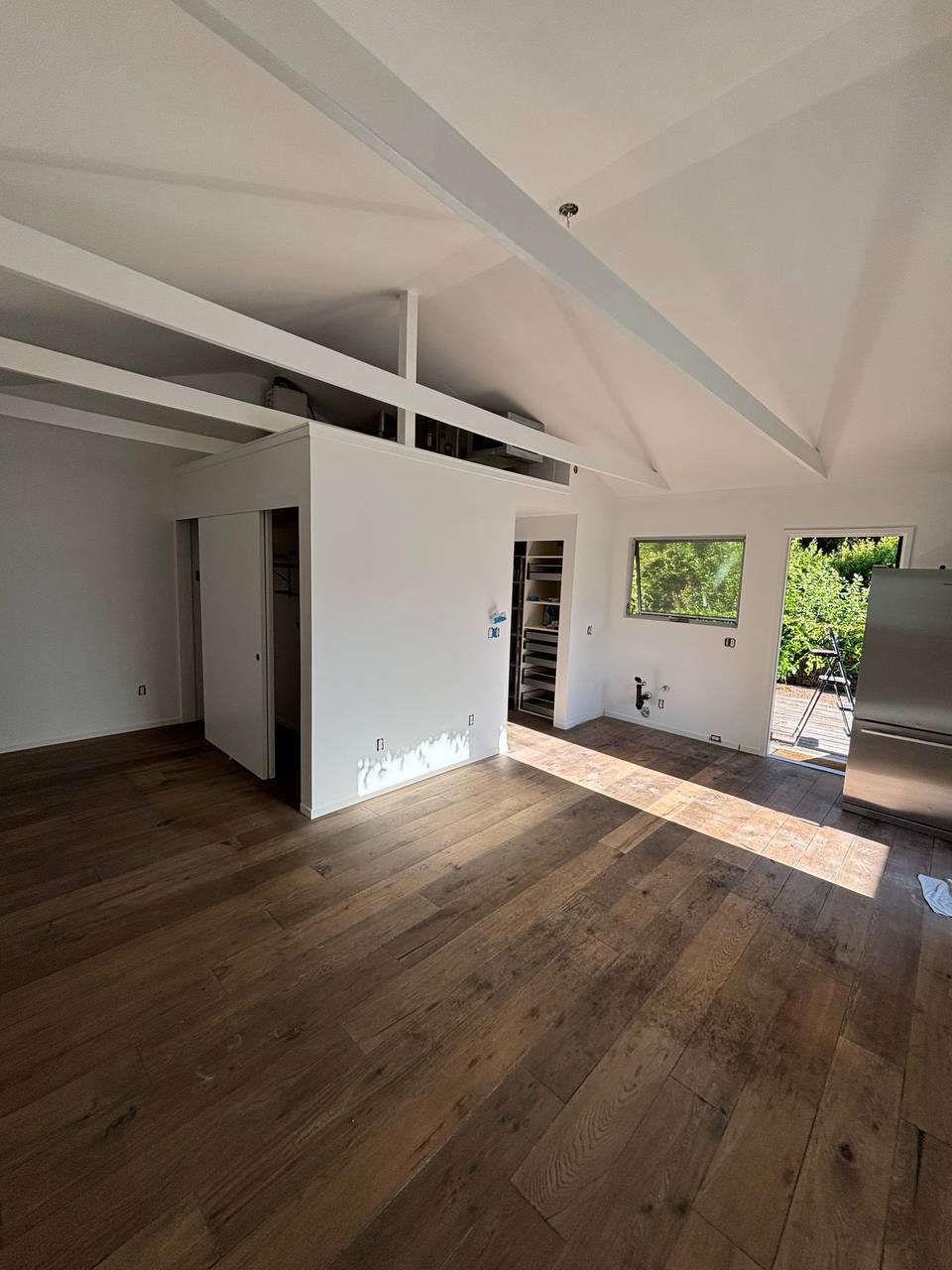

Why the photos are of empty rooms

Because staging hides work. Flat walls, a straight run of flooring, crisp door reveals and a ceiling with no telegraphing patch lines are only visible in a bare room with daylight raking across them. That is the standard we want to be judged on.
